Santa Barbara North Enters the Final Phase of Highway 101 Expansion
The effort to modernize the Central Coast’s primary transportation artery is entering its definitive stage. This spring 2026, construction officially expands into the Santa Barbara North segment, a vital portion of the 10.9-mile Highway 101: Carpinteria to Santa Barbara project. This milestone represents the culmination of a strategic partnership between Caltrans and the Santa Barbara County Association of Governments (SBCAG) to alleviate regional congestion and enhance motorist safety.
This final expansion integrates advanced engineering solutions with long-term infrastructure goals to eliminate a notorious four-lane bottleneck. By focusing on the stretch between Hermosillo Road and Salinas Street, regional planners will complete a continuous forty-mile, six-lane facility extending from the Ventura and Oxnard urbanized area through to the City of Goleta.
Photo courtesy of Santa Barbara County Association of Governments (SBCAG)
Infrastructure Upgrades for Modern Travel
The project encompasses a precise 10.9-mile corridor from 0.22 miles south of Bailard Avenue to Sycamore Creek. A central feature of this phase is the addition of part-time, peak-period carpool lanes in both directions. These continuous access HOV lanes serve as a core component of the region’s broader strategy to manage high-occupancy vehicle travel during the most congested hours.
Beyond capacity expansion, the project involves a sophisticated overhaul of regional infrastructure. Major work focuses on the reconstruction of the interchanges at Cabrillo Boulevard and Sheffield Road. Engineers are also replacing or widening several creek bridges and undercrossing structures to accommodate the new six-lane profile. The scope further includes mainline rehabilitation, replacing existing pavement, widening shoulders, and improving ramps from Casitas Pass Road to Sheffield Avenue.
Photo courtesy of Santa Barbara County Association of Governments (SBCAG)
Strategic Phasing Throughout the Corridor
Planners divided the project into five geographic segments to ensure manageable construction progress. While work has been active since 2024 in the southern sections—including the Santa Barbara South segment between Olive Mill and Hermosillo Roads—the upcoming activation of the North segment represents the next major frontier. The designated work zones include:
-
Segment 4A: Bailard Avenue to Carpinteria City Limit.
-
Segment 4B: Carpinteria City Limit to north of North Padaro Interchange.
-
Segment 4C: North of North Padaro to North of Sheffield Interchange.
-

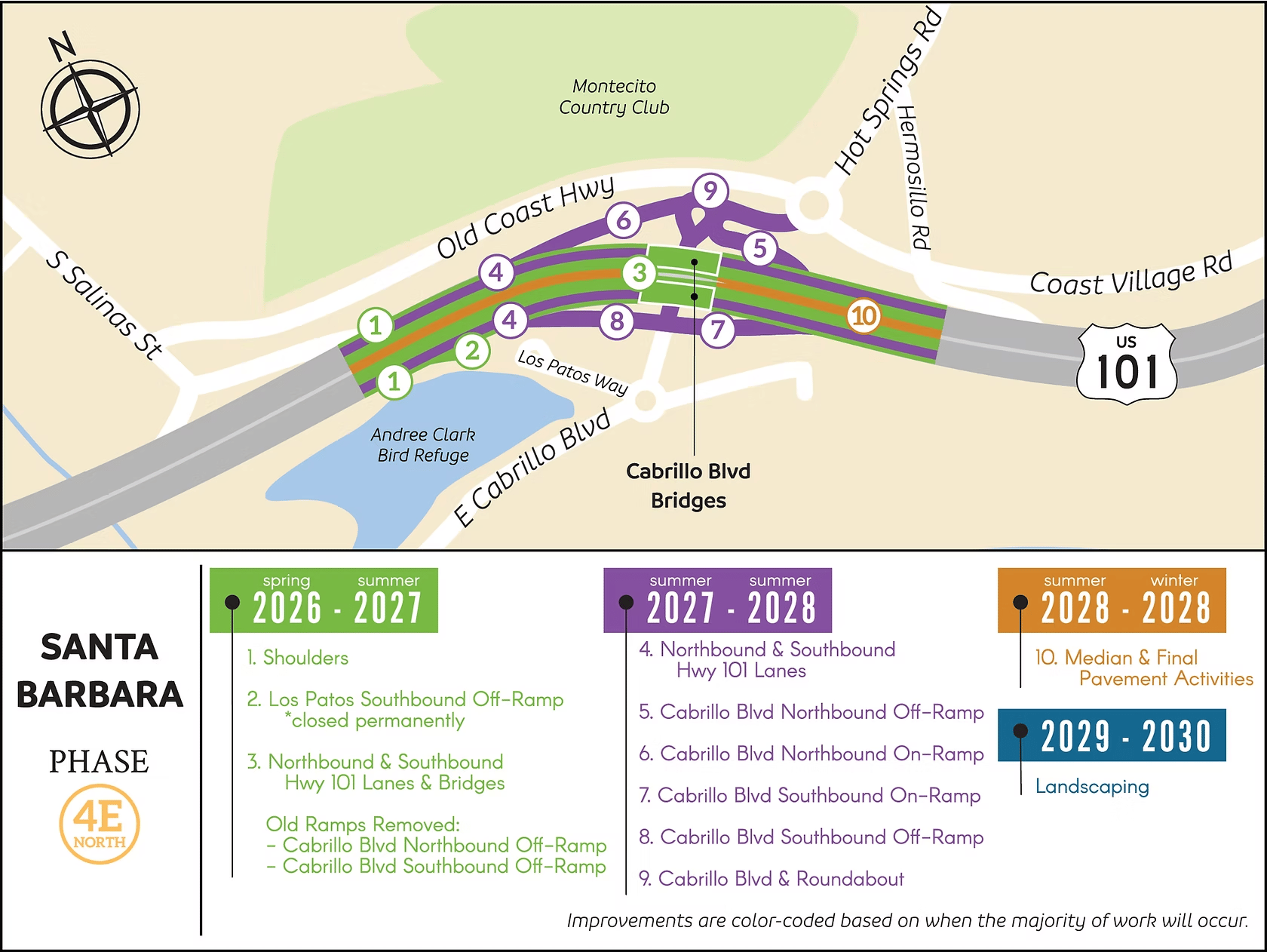

Segments 4D and 4E: North of Sheffield Interchange to Sycamore Creek, containing the Santa Barbara North and South work areas.
Construction began in the south with Segment 4A, which overlapped with the Phase 3 Linden-Casitas project. While segments have proceeded progressively, the start of work in Santa Barbara North ensures that the entire 10.9-mile scope is under active development. This phase is scheduled to continue through 2028, at which point the full corridor is expected to be built out.
Environmental Stewardship in the Coastal Zone
The project is located entirely within the coastal zone, requiring rigorous environmental clearance and specific development permits. Key regulatory steps involved securing Local Coastal Program Amendments (LCPA) in the City of Carpinteria and the County of Santa Barbara to align with regional land-use policies.
To protect the local ecosystem, crews adhere to strict environmental commitments. This management approach navigates sensitive wetland buffer policies, particularly in Segments 4B and 4C. Furthermore, intricate coordination with the Union Pacific Railroad is required for bridge construction at Arroyo Parida Creek and Toro Creek to ensure that highway improvements do not disrupt rail operations.
Fiscal Investment Supporting Regional Growth
The Highway 101 expansion is a significant public investment with a total estimated cost of approximately $700 million. Funding comes from a diversified portfolio of state and local resources. State contributions include the State Transportation Improvement Program (STIP) and the State Highway Operation and Protection Program (SHOPP). Local support is driven by the Measure A sales tax, which was passed by 79 percent of voters with this HOV project as its flagship initiative.
To maximize efficiency, the project utilizes the Construction Manager/General Contractor (CM/GC) delivery method. This approach encourages early collaboration between the design team and the contractor. This synergy helps identify potential innovations, manage schedule risks, and minimize construction-related travel delays for the Santa Barbara community. Residents can sign up for biweekly updates at SBROADS.com to stay informed on specific lane closures and progress milestones.
